Tampa · Brandon · Riverview · Carrollwood · Lutz (813) 285-7026
Tampa Driveway Paving
A freshly paved asphalt driveway curving up to a Florida home under late-afternoon light

Tampa · Hillsborough · Pasco

Asphalt paving,
built from the base up.

Driveways, parking lots, private roads and HOA resurfacing. Every job engineered from the subgrade — because in Florida sand, that is what decides whether it lasts fifteen years or five.

8in Minimum compacted base under a residential drive
2 lifts Base placed and compacted in layers, then proof-rolled
15+ yrs What a properly built surface should give you here
24hr Quote turnaround once a job has been measured

Build specification

The standard every job is built to.

The same specification runs a residential driveway and a commercial lot. Only the depths and the plant change with the load the surface has to carry.

StageWhat we doWhy it is specified that way
Subgrade Cut to depth, graded to fall, proof-rolled dry before anything goes on it Florida sand carries load once compacted. Worked wet or left loose, it moves under the surface.
Base Crushed limerock placed in lifts, each one compacted and proof-rolled. Eight inches minimum residential; deeper where vehicle loads require it The base is the structural layer. It spreads load so the asphalt is never asked to bridge anything.
Drainage Fall confirmed across the finished surface before paving, outfall checked Standing water is the single most reliable way to destroy a pavement from underneath.
Asphalt Hot mix laid and rolled while at temperature, in two lifts where the load calls for it Compaction only happens in a working temperature window. Miss it and density is lost permanently.
Edges Cut clean and supported, tied properly into concrete, garage thresholds and the road Unsupported edges are where a pavement starts failing first, regardless of how good the middle is.
Joints Sealed at every tie-in and cold joint A joint is an open route to the base. Sealed, it stays a joint; unsealed, it becomes a crack.
Weather No paving over saturated ground. Summer dates carry a weather window Rain on a fresh mat or an open subbase cannot be corrected afterwards, only rebuilt.

Every quote we issue names the base depth and the number of lifts. It is the part of the work you cannot inspect once there is asphalt over it, so it belongs in writing before anyone starts.

Figure 1 — what is under a Tampa driveway

The part you never see decides how long it lasts.

Asphalt is the thin bit at the top. Everything that determines whether your driveway is flat in ten years happens below it, in ground that here is mostly sand.

Cross-section of a correctly built Tampa asphalt driveway Four layers from the top: asphalt surface, compacted crushed limerock base, compacted sand subgrade, and the seasonal high water table below. Asphalt Base Sand Water The 8 inches that matter
  1. AsphaltThe wearing surface. Two lifts on a driveway that will take vehicle weight daily.
  2. Crushed baseCompacted limerock. This is the structural layer — it spreads load so the asphalt never has to.
  3. Sand subgradeFlorida ground. Compacted and proof-rolled dry, it holds. Left loose or worked wet, it moves.
  4. Water tableHigh across much of Hillsborough. Water reaching an uncompacted subbase is how driveways sink.

If water reaches the subbase before the asphalt goes down, the ground under it softens. Everything above then sinks and cracks — on a driveway and on a parking lot alike.

The reason we proof-roll dry and stop for weather

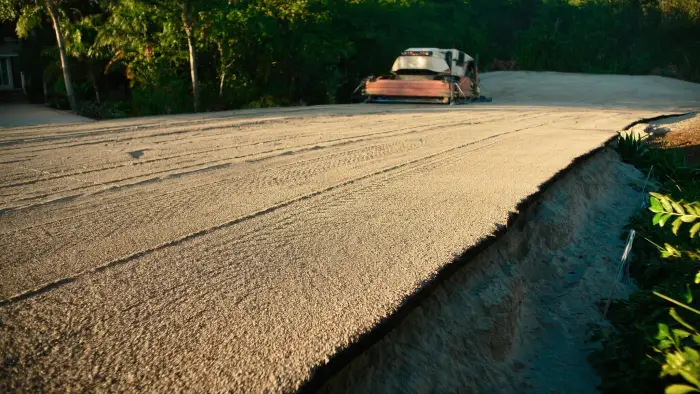

Eight inches is our normal figure for a residential driveway, and like every number in this trade it is a starting point rather than a rule. A drive that will only ever see two family cars on firm ground can sit on less. One that takes a work truck, a boat trailer or an RV needs more, and so does anything being built over ground that has been disturbed — a filled swale, an old trench, backfill around a new build that has not had years to settle.

What does not change is the method. Stone goes in and gets compacted in layers, not tipped in one lift and rolled once on top. Each layer gets proof-rolled so soft spots show themselves while they are still cheap to fix. And none of it happens on saturated ground, which in a Tampa summer is a scheduling problem as much as a technical one.

When you compare quotes, this is the part to ask about. It is the largest single share of the work, it is where a cheaper number usually comes from, and it is the one thing you can never inspect once there is asphalt over it.

Figure 2 — core sample

Take a sample of the same driveway.

Move across it. Underneath is the surface this replaced — twenty years old and failing, not from wear but from a base that gave up beneath it.

The driveway newly paved in smooth black asphalt
The same driveway before replacement: alligator cracking across the whole surface, weeds through the joints and edges crumbling away where nothing supported them.

How a driveway goes in

Four days, most of them not paving.

  1. We come out and measure

    Square footage, access for the truck, where water runs now and where it should run. You get the number and the plan in writing, with no obligation attached to it.

  2. Tear-out and grading

    Old surface off, subgrade cut to depth, low spots corrected. If the ground is wet we stop and wait — this is the step where rushing costs you the driveway.

  3. Base and compaction

    Crushed limerock in lifts, each one compacted and proof-rolled. Flat, dry and solid before a drop of asphalt arrives.

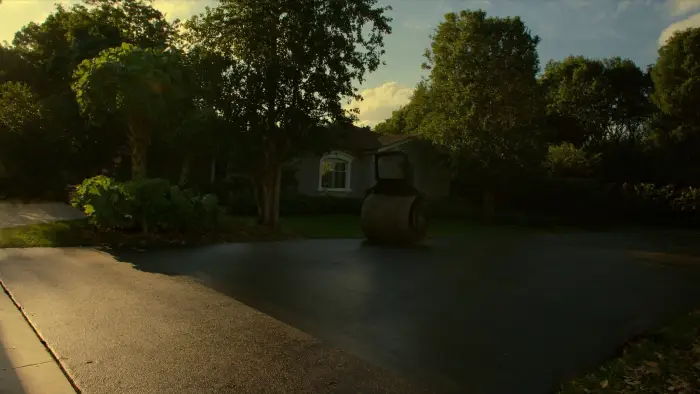

  4. Paving and rolling

    Hot mix laid and rolled while it is at temperature, edges cut clean, joints sealed. Walk on it that evening, park on it the next day.

Tell us what the surface has to carry.

Family cars, delivery vehicles, a full parking lot — the answer changes the build. Send the details and we will scope it properly.

Local conditions

Four things Tampa does to asphalt.

Sand that moves

The dominant failure mode here is not the asphalt — it is what is under it. Sandy subgrade over a high water table shifts when it is loaded wet. Compaction and drainage are the whole defence, and both happen before paving starts.

Sun that dries it out

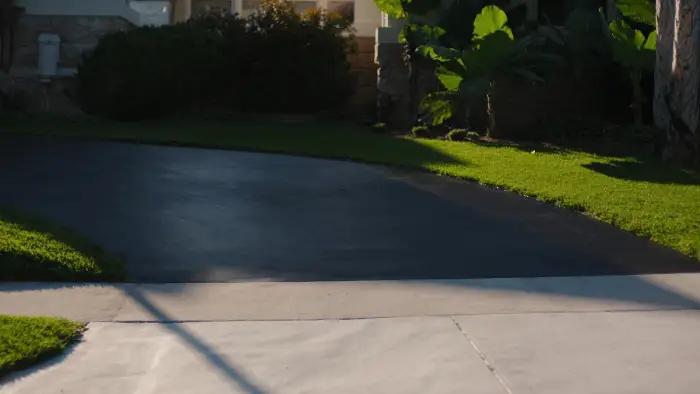

UV oxidises the binder holding asphalt together. It fades from black to grey, goes brittle, then cracks. This is why sealcoating is genuine maintenance in Florida rather than a cosmetic add-on sold at the door.

Afternoon storms

June to September, most afternoons. Rain on fresh asphalt or a soaked subbase ruins the work. Any quote we give in that window carries a weather clause, and we would rather move a date than lay over wet ground.

Storm water

Helene undercut driveways and washed out culverts across the area in 2024. Where water leaves your drive matters as much as what it is made of, so we look at grade and outfall before quoting a surface.

The other options

Asphalt is not always the answer.

Specifying the surface is part of the job. Three materials come up on Tampa properties, and the right one depends on what the surface carries, how the ground under it behaves and how you want it to look in ten years.

Hot mix asphalt is the default for most driveways, lots and private roads here. It flexes with a sandy subgrade instead of cracking in slabs, goes down fast enough to keep a property usable, and can be resurfaced later without tearing out the structure underneath.

Concrete lasts longer and stays cooler underfoot through a Tampa July. It costs more, takes longer before it can be used, and when it does crack the repair is a slab replacement that rarely colour-matches. On ground that moves it is the less forgiving choice, which is why asphalt dominates in this part of Florida.

Asphalt millings are recycled asphalt, laid and compacted in place. They suit long approaches, service access and overflow parking where a smooth cut edge matters less than durability underfoot. They need topping up and regrading over the years, and they will never look like hot mix.

We will tell you which of the three your site actually calls for at the site visit, before any number is quoted.

What we take on

Residential and commercial, same specification.

The build standard does not change with the client. What changes is the depth of the base, the plant on site and how the work is phased so a property stays open.

Residential driveways

New driveways, full replacement and resurfacing. Single drives through to long approaches, turning circles and parking spurs.

Parking lots

Paving, resurfacing and repair for commercial sites, retail units, offices and places of worship. Phased so the lot keeps working while we are on it.

HOA and community

Private roads, shared driveways and community parking areas, scheduled around residents and quoted for a board rather than an individual.

Striping and markings

Layout and re-striping after resurfacing, including accessible bays, fire lanes and directional markings, so the surface is usable as soon as it cures.

Milling and reclamation

Milling off failed surface, reclaiming the material and rebuilding to level where a full tear-out is not the right answer.

Aprons and approaches

The tie-in to the public road, where right-of-way rules apply and the levels and drainage have to be right the first time.

Straight answers

The questions we get asked.

On the phone, at the site visit, and on the day. Answered the same way here.

How long does an asphalt driveway last in Tampa?

Fifteen to twenty years is normal for a driveway built on a properly compacted base and sealed every few years. Florida shortens that when the base is thin or the sand underneath was never compacted — the surface then sinks and cracks long before the asphalt itself wears out.

Should I pick concrete or asphalt for a Florida driveway?

Asphalt goes down in a day or two, flexes with a shifting sandy subgrade instead of cracking in slabs, and is straightforward to resurface later. Concrete lasts longer and stays lighter in the sun, but it is rigid, so ground movement shows up as slab cracking. On most Tampa lots the subgrade decides it, and we will tell you which way yours points at the site visit.

Is discount driveway sealing a scam?

The door-to-door version usually is. The common pattern is a crew with leftover material, a price quoted on the spot, and a coat thinned out so far it powders off within months. Real sealcoating needs a clean, dry, properly cured surface and a measured application. Anyone who cannot tell you what they are spraying is not worth hiring.

How soon can you start?

We come out and measure, then put the scope and the number in writing. Most residential driveways are scheduled within a couple of weeks; commercial work is phased around how the site operates. From June to September every date carries a weather window, because rain on a wet subbase ruins the job.

Do I need a permit to redo my driveway?

If the work stops short of the road you usually do not. Replacing the apron out to the road edge pulls in the right-of-way office — City of Tampa review runs about 12 to 15 business days. We tell you which side of that line your job falls on before you commit.

Do you take on commercial and HOA work?

Yes. Parking lots, private roads, community and shared driveways, striping and milling, alongside residential drives. The specification is the same either way — what changes is base depth, plant and phasing so the property keeps operating while we are on it.

How large a job will you take?

Tell us the surface area and what it has to carry and we will scope it. We build to the same standard from a single driveway up, and we will say plainly at the site visit what the job needs rather than quoting around it.

Where we work

Tampa and the ring around it.

  • Tampa
  • Brandon
  • Riverview
  • Carrollwood
  • Westchase
  • Temple Terrace
  • New Tampa
  • Seminole Heights
  • Lutz
  • Odessa
  • Wesley Chapel

Odessa and Wesley Chapel sit in Pasco County and Lutz straddles the line, so the permit rules there are not Hillsborough’s. We check which office your job answers to before quoting it.

No obligation

Tell us about the driveway.

Rough size and what is wrong with it now is enough to start. We come out to measure before any number is final.

Rather talk? (813) 285-7026, weekdays 7–6.

Roughly how big, and what it looks like now.

We reply inside one working day.

Call (813) 285-7026 Quote
Get a quote
